Timescales and next steps

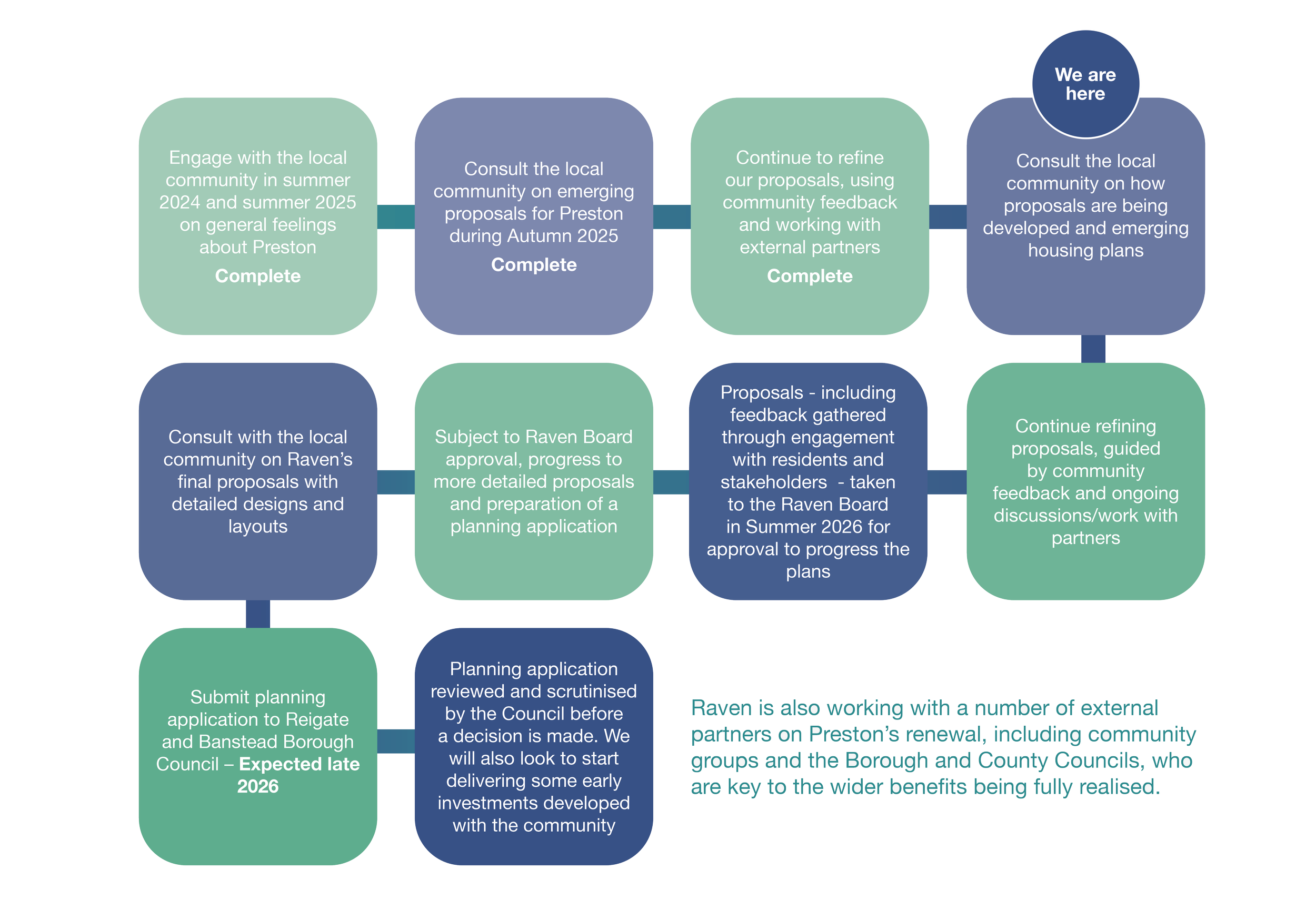

The table below sets out the consultation and proposal timeline through to submission of the planning application to Reigate and Banstead Borough Council.
If planning consent is granted, the work will be carried out in stages, as shown on the phasing timeline below
We are committed to keeping you updated on the timelines and will inform you of any changes to the phasing programme
Raven remains committed to maintaining homes so they stay safe and fit for purpose, and keeping the area well maintained throughout this process.

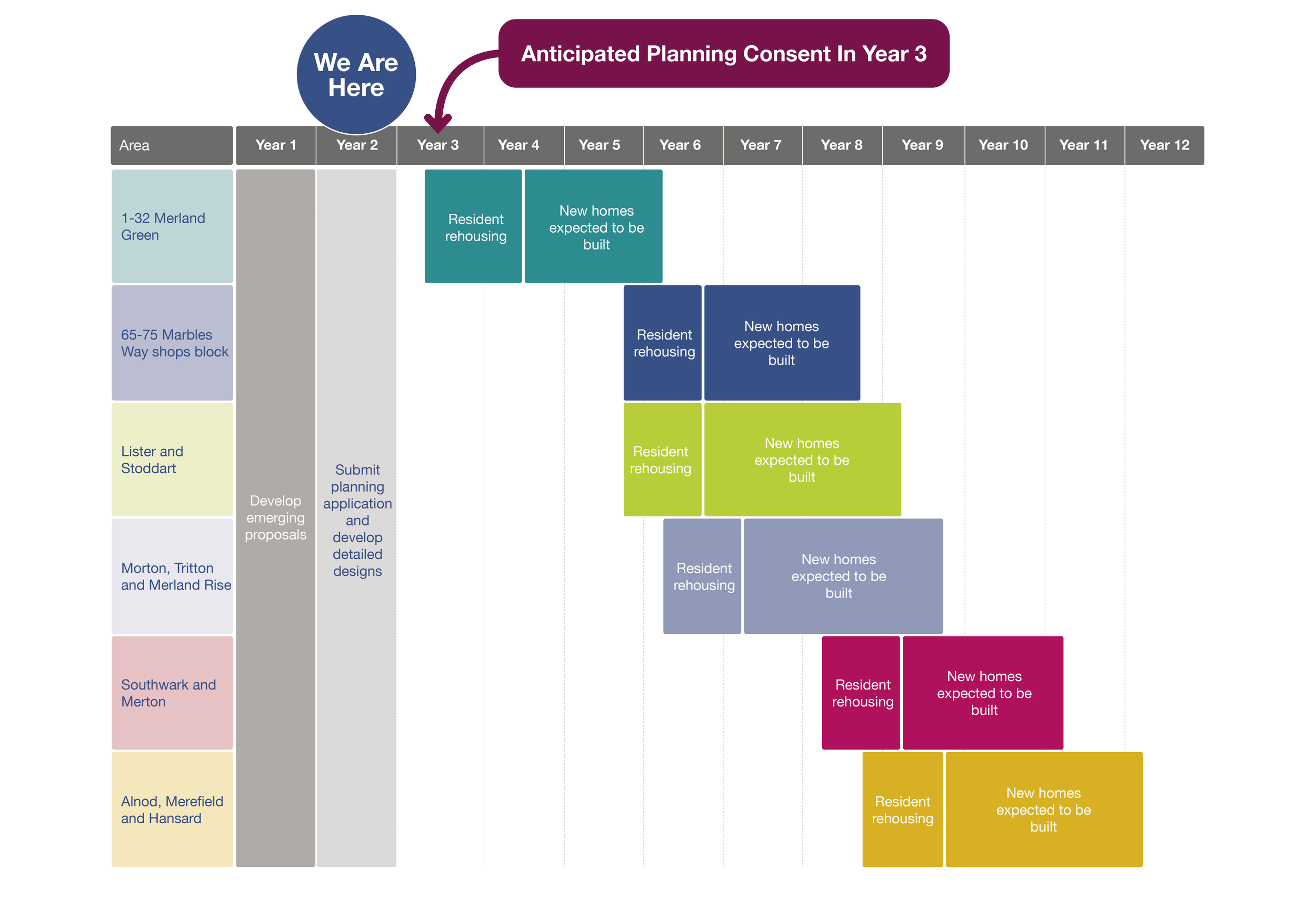

Proposed phasing and timeline
This timeline shows the potential schedule for each area. It is designed to give residents a guide on when rehousing is likely to begin and when the new homes are expected to be completed. The dates may change but we’ll keep you informed.
The renewal project would take place in stages. This approach means:
The number of residents and businesses experiencing disruption at any one time is minimised
New homes are ready before the next phase, helping keep the community together.
Click on the images to enlarge
Key points to bear in mind are:
These are emerging plans and nothing has been finalised or agreed
We will work closely with the community as the proposals develop, with ongoing events and engagement opportunities planned
Our investment plans would take a number of years and the bigger changes would take place in stages
The redevelopment of homes would not start for at least two years
Directly affected residents are being fully supported throughout the process.
